Engineers, ship captains and welders are steadily preparing a scheme set to reshape travel in northern Europe, with each enormous tunnel segment forming part of the change.
A 19 km shortcut beneath the Baltic
The Fehmarnbelt Fixed Link will join Rødbyhavn in Denmark with Puttgarden in Germany via an immersed tunnel installed on the seabed. When it opens, motorists and rail passengers will traverse the strait in minutes, rather than spending almost an hour on a ferry.
At roughly 18 kilometres in length, the tunnel will rank among the world’s longest immersed road and rail tunnels. Separate tubes will accommodate a four-lane motorway and two electrified railway tracks, alongside a service corridor.
The backbone of the entire link is a chain of hollow concrete segments, each as heavy as a small cruise ship.
The segments are manufactured on land at a purpose-built factory. They are then floated out, pulled to the Fehmarnbelt by tugboats and lowered, with millimetre-level accuracy, into a prepared seabed trench.
The arrival of two maritime giants

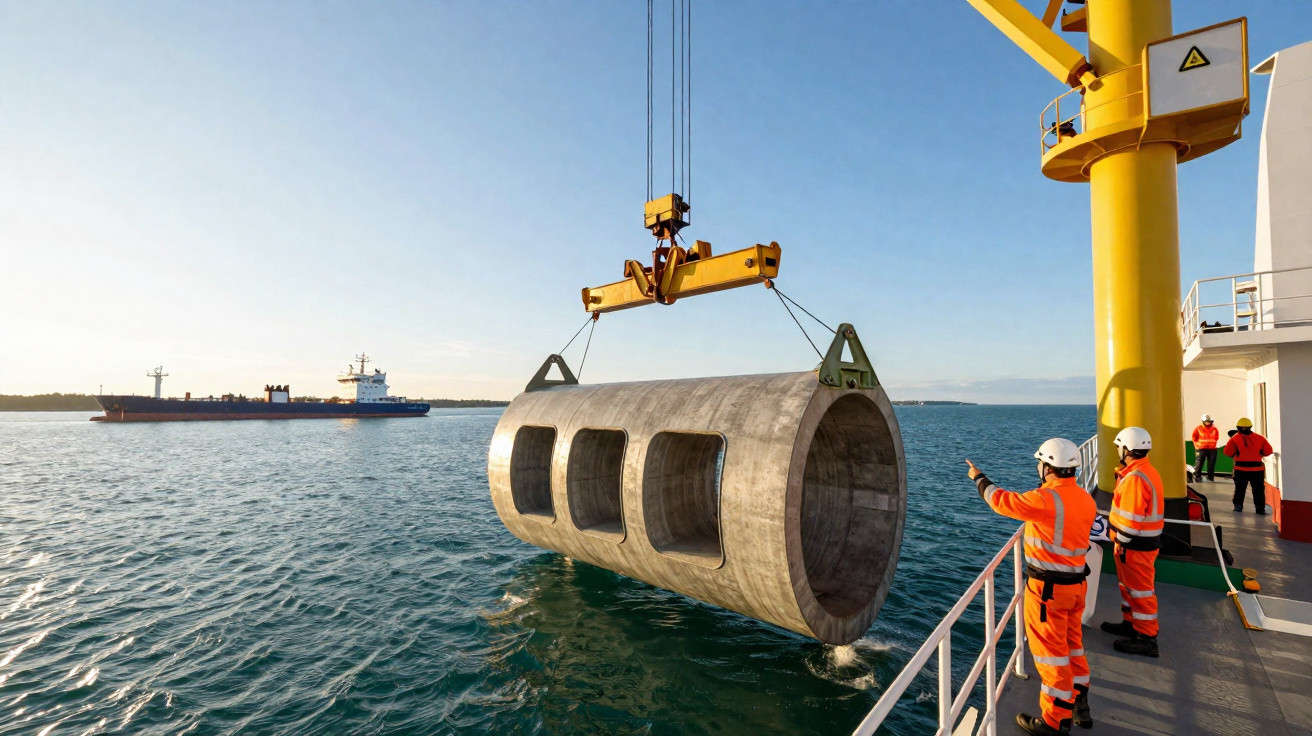

For months, one vital part of the project has remained pending: two huge specialist vessels created to manage the 73,000-tonne tunnel elements. The concrete sections could not be positioned accurately on the seabed without them.
Sometimes characterised as “mega-floating cranes” with precision-positioning systems, these ships have been designed specifically for this work. Each vessel can hold its position against wind, waves and currents while lowering a vast concrete unit dozens of metres below the surface.
Each standard tunnel element is roughly 217 metres long, weighs up to 73,000 tonnes, and must be aligned within a few centimetres.
The vessels operate as precisely coordinated partners. One manages a segment’s forward end, while the other controls its aft end. Their crews use GPS, sonar and laser guidance to achieve the precise location set by engineers on land.
Why the tunnel needed to “wait” for them
Preparatory work at the Fehmarnbelt has continued, including seabed dredging, the installation of protective layers and completion of the dedicated element factory at Rødbyhavn. Yet the most sensitive phase-installing the elements-had to wait until the heavy-lift ships had passed testing and certification.
A series of tests in calmer water examined the ballast systems, winches, cables and safety procedures. A failure while a 73,000-tonne block was suspended beneath a ship would create a major danger to people, machinery and the environment.
Only once those inspections had been completed could the vessels travel to the Baltic, where suitable weather windows are limited and conditions may shift quickly.
How an immersed tunnel is built, step by step
The role of these maritime giants becomes clearer when the construction sequence is divided into its main stages:
- Excavation: Dredgers remove material to form a trench along the planned route, which may reach 16 metres in depth.
- Seabed preparation: Gravel and crushed rock are placed to provide a stable, level base.
- Element construction: Enormous concrete segments are cast at a factory, allowed to cure and fitted with internal systems.
- Float-out: The sealed hollow elements are floated out, resembling giant vessels with blunt ends.
- Towing and positioning: Tugboats and the two heavy-lift vessels move the element and keep it in place above the trench.
- Immersion: Ballast water is added in stages, while winches lower the segment onto the seabed.
- Connection: Divers and remote-controlled systems join every new segment to the preceding one using gaskets and steel joints.
- Backfilling and protection: Gravel and rock are placed over the tunnel to protect it from anchors and currents.
The two new vessels take centre stage during the final four stages, when accuracy is especially important.
Engineering under pressure
Installing a 73,000-tonne element requires more than raw lifting power; it demands control. Baltic currents exert sideways pressure, winds load the vessels above, and water pressure rises as the element descends.
Onboard crews monitor a bank of screens displaying live information on position, depth, angle, tension in every cable and the gap to the previous tunnel section. Engineers can alter the ballast tanks to move the segment’s centre of gravity while it hangs beneath the hull.
The acceptable margin of error is tiny: alignment must stay within a few centimetres over a length of more than two football pitches.
On the seabed, the element settles onto neoprene and rubber seals that create a watertight connection. Hydraulic jacks carefully draw the new segment towards the one already installed, compressing the seals and securing the two units together.
Why size matters for these ships
The vessels’ dimensions are dictated by the segments’ weight and shape. A smaller ship would pitch and roll more in waves, making accurate installation almost impossible.
Their broad hulls and multiple lifting points spread the load, reducing the likelihood of excessive stress on the concrete. The ships are also sufficiently long to distribute buoyancy, keeping the combined vessel-and-segment system stable as ballast changes during immersion.
Transforming travel between Scandinavia and central Europe
The Fehmarnbelt tunnel is frequently called a “missing link” between Scandinavia and the rest of Europe. At present, travellers largely depend on ferries or longer routes through mainland Denmark.
| Mode | Current typical time | Projected time with tunnel |
|---|---|---|
| Car (including ferry) | Approximately 45 minutes on the ferry, plus waiting and loading | Around 10 minutes through the tunnel |
| Rail (Hamburg–Copenhagen) | About 4.5 hours | Potentially around 2.5–3 hours |
The implications for freight are equally substantial. Goods trains travelling from Sweden and Norway to continental Europe will no longer be tied to ferry timetables or weather-related cancellations. Logistics planners anticipate more dependable delivery times and possibly reduced costs.
Economic and environmental stakes
Danish and German authorities describe the tunnel as both an economic route and a climate initiative. Moving long-distance passengers and freight from road and air towards electrified rail could reduce emissions along major routes.
Construction has nevertheless prompted concerns from environmental organisations. The Fehmarnbelt strait is home to porpoises, seabirds and sensitive marine habitats. Dredging and noise may disrupt wildlife, while altered currents could affect seabed ecosystems.
Project planners argue that early, extensive mitigation-quiet piling techniques, adapted work schedules, and monitoring-can limit long-term impact.
Independent researchers will monitor biodiversity in the area for years after the opening to determine whether the promised safeguards are effective.
Why immersed tunnels instead of a bridge?
At an early stage, engineers considered building a long cable-stayed or suspension bridge across the Fehmarnbelt. They ultimately selected an immersed tunnel for several reasons.
- Weather exposure: Baltic conditions can be windy and icy, so a bridge deck would be more prone to closures.
- Navigation: a tunnel removes the need for extremely tall pylons and wide navigation spans for large ships.
- Visual impact: an underwater crossing alters the skyline less than a vast bridge structure.
- Rail constraints: controlled tunnel inclines make gradients for high-speed trains easier to manage.
However, immersed tunnels involve complicated marine construction and require long-term waterproofing measures. Their joints must remain sealed for decades, while maintenance access is more restricted than it would be on a bridge.
Key terms that often confuse people
Project documentation uses several technical expressions that may seem unclear. Two of the most common are “immersed tunnel” and “segment”.
An immersed tunnel is not drilled through rock in the manner of the Channel Tunnel. Instead, it is assembled from prefabricated elements that are placed in a dredged trench and subsequently covered. The structure lies on, or just beneath, the seabed rather than far underground.
In this setting, a tunnel segment is a huge concrete box containing internal walls, ventilation ducts and emergency passages. Much of the electrical and mechanical equipment is installed by workers while the segment remains in the factory, before it enters seawater.
Looking ahead: what could this enable next?
The Fehmarnbelt link forms part of a wider European corridor strategy. Transport planners envisage overnight freight services running from Stockholm to Milan without ferry transfers, as well as daytime passenger trains that could make rail more competitive with short-haul flights.
Techniques proven on the project-particularly the use of bespoke vessels to handle extremely heavy segments-could shape later schemes. Coastal cities dealing with sea-level rise are already considering whether immersed structures might combine transport connections with flood defences or utility tunnels.
Engineers are also discreetly modelling potential risks, including ship collisions, submarine landslides, unforeseen seabed settlement and extensive power failures. Every scenario informs contingency provisions, ranging from emergency lighting to cross-passages that allow passengers to move between tunnel tubes.
For drivers eventually crossing the Baltic in ten quiet minutes, much of this complexity will be unseen. Yet beneath their wheels, a sequence of 73,000-tonne concrete giants, installed by two equally formidable ships, will carry out its silent role for decades.
